Longest Job First Algorithm-
In LJF Scheduling,
- Out of all the available processes, CPU is assigned to the process having largest burst time.
- In case of a tie, it is broken by FCFS Scheduling.
- LJF Scheduling can be used in both preemptive and non-preemptive mode.
- Preemptive mode of Longest Job First is called as Longest Remaining Time First (LRTF).
Advantages-
- No process can complete until the longest job also reaches its completion.
- All the processes approximately finishes at the same time.
Disadvantages-
- The waiting time is high.
- Processes with smaller burst time may starve for CPU.
PRACTICE PROBLEMS BASED ON LJF SCHEDULING-
Problem-01:
Consider the set of 5 processes whose arrival time and burst time are given below-
Process Id | Arrival time | Burst time |
P1 | 0 | 3 |
P2 | 1 | 2 |
P3 | 2 | 4 |
P4 | 3 | 5 |
P5 | 4 | 6 |
If the CPU scheduling policy is LJF non-preemptive, calculate the average waiting time and average turn around time.
Solution-

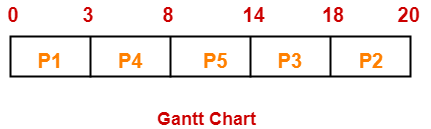

Gantt Chart-
Now, we know-
- Turn Around time = Exit time – Arrival time
- Waiting time = Turn Around time – Burst time
Also read-Various Times of Process
Process Id | Exit time | Turn Around time | Waiting time |
P1 | 3 | 3 – 0 = 3 | 3 – 3 = 0 |
P2 | 20 | 20 – 1 = 19 | 19 – 2 = 17 |
P3 | 18 | 18 – 2 = 16 | 16 – 4 = 12 |
P4 | 8 | 8 – 3 = 5 | 5 – 5 = 0 |
P5 | 14 | 14 – 4 = 10 | 10 – 6 = 4 |
Now,
- Average Turn Around time = (3 + 19 + 16 + 5 + 10) / 5 = 53 / 5 = 10.6 unit
- Average waiting time = (0 + 17 + 12 + 0 + 4) / 5 = 33 / 5 = 6.6 unit
Problem-02:
Consider the set of 4 processes whose arrival time and burst time are given below-
Process Id | Arrival time | Burst time |
P1 | 1 | 2 |
P2 | 2 | 4 |
P3 | 3 | 6 |
P4 | 4 | 8 |
If the CPU scheduling policy is LJF preemptive, calculate the average waiting time and average turn around time.
Solution-
Gantt Chart-
Now, we know-
- Turn Around time = Exit time – Arrival time
- Waiting time = Turn Around time – Burst time
Process Id | Exit time | Turn Around time | Waiting time |
P1 | 18 | 18 – 1 = 17 | 17 – 2 = 15 |
P2 | 19 | 19 – 2 = 17 | 17 – 4 = 13 |
P3 | 20 | 20 – 3 = 17 | 17 – 6 = 11 |
P4 | 21 | 21 – 4 = 17 | 17 – 8 = 9 |
Now,
- Average Turn Around time = (17 + 17 + 17 + 17) / 4 = 68 / 4 = 17 unit
- Average waiting time = (15 + 13 + 11 + 9) / 4 = 48 / 4 = 12 unit
Problem-03:
Consider three processes (process id 0, 1, 2 respectively) with compute time bursts 2, 4 and 8 time units. All processes arrive at time zero. Consider the longest remaining time first (LRTF) scheduling algorithm. In LRTF, ties are broken by giving priority to the process with the lowest process id. The average turn around time is-
- 13 unit
- 14 unit
- 15 unit
- 16 unit
Solution-
We have the set of 3 processes whose arrival time and burst time are given below-
Process Id | Arrival time | Burst time |
P1 | 0 | 2 |
P2 | 0 | 4 |
P3 | 0 | 8 |
Gantt Chart-
Now, we know-
Turn Around time = Exit time – Arrival time
Process Id | Exit time | Turn Around time |
P1 | 12 | 12 – 0 = 12 |
P2 | 13 | 13 – 0 = 13 |
P3 | 24 | 14 – 0 = 14 |
Now,
Average Turn Around time = (12 + 13 + 14) / 3 = 39 / 3 = 13 unit
Thus, Option (A) is correct.
